Key takeaways
- The honest industry timeline for a B2B SaaS redesign is 12–16 weeks for a standard marketing site, stretching to 26–30 weeks for a complex enterprise build; we compress the same six phases to 3–4 weeks with a pre-built design system, parallel tracks and page-count discipline.
- Scope creep and slow stakeholder feedback loops, not the design or build work itself, are the most commonly cited reasons redesigns run long.
- Ranking loss in a redesign almost always traces to a missing redirect map or dropped metadata, not the new design itself — the pre-launch SEO checklist is what protects it.
If you're planning a B2B SaaS website redesign, the honest industry answer on timeline is 12–16 weeks for a standard marketing site, stretching to 26–30 weeks for a complex enterprise build with heavy integrations and content migration. That's the range you'll see across current agency guides and project breakdowns. We rebuild B2B SaaS marketing sites in 3–4 weeks, which is faster than even the "simple SaaS/MVP" tier most guides quote — so this piece covers both what the realistic market timeline looks like and how a compressed process gets there without cutting the steps that protect your rankings and pipeline.
We're a Webflow agency for B2B SaaS teams that does exactly this kind of rebuild, so read the compressed-timeline sections with that bias in mind. The rest — the signs it's time, the phase breakdown, the SEO checklist — applies regardless of which agency or timeline you choose.
Signs it's time to redesign
A redesign is worth the disruption when more than one of these is true:
- Demo or trial conversion is falling even as traffic holds steady or grows — the site is the leak, not the channel.
- Your positioning has moved on but the site hasn't. Repriced, re-targeted, or re-launched the product and the homepage still pitches last year's story.
- Marketing can't ship without a developer. Every landing page or pricing tweak becomes a ticket, and campaigns wait on a sprint.
- Page speed and Core Web Vitals are dragging on a platform that's expensive to fix incrementally.
- The design looks and feels dated next to the tools your buyers evaluate you alongside — a real, if harder to quantify, trust signal.
One of these alone might just need a targeted fix. Two or three together usually mean the underlying structure, not just the visual layer, needs to change. If you're at this stage, the next two questions you're probably weighing are how long it will take and what it costs — both covered below with real published ranges, not a single agency's guess.
How long does a website redesign actually take?
Published timeline breakdowns from agencies currently doing this work cluster around a few tiers:
- Simple SaaS site or MVP: roughly 6–8 weeks.
- Standard B2B SaaS marketing site (multiple page types, a blog, some integrations): commonly cited at 8–16 weeks, with several current guides converging on 12–16 weeks as the realistic middle.
- Complex B2B builds with custom flows, localization, or a large content migration: 18–30 weeks.
The most commonly cited reasons a redesign runs long aren't the design or build work itself — they're scope creep (features added mid-project) and stakeholder feedback loops (multiple approvers with conflicting notes), both of which stretch almost any timeline regardless of platform.

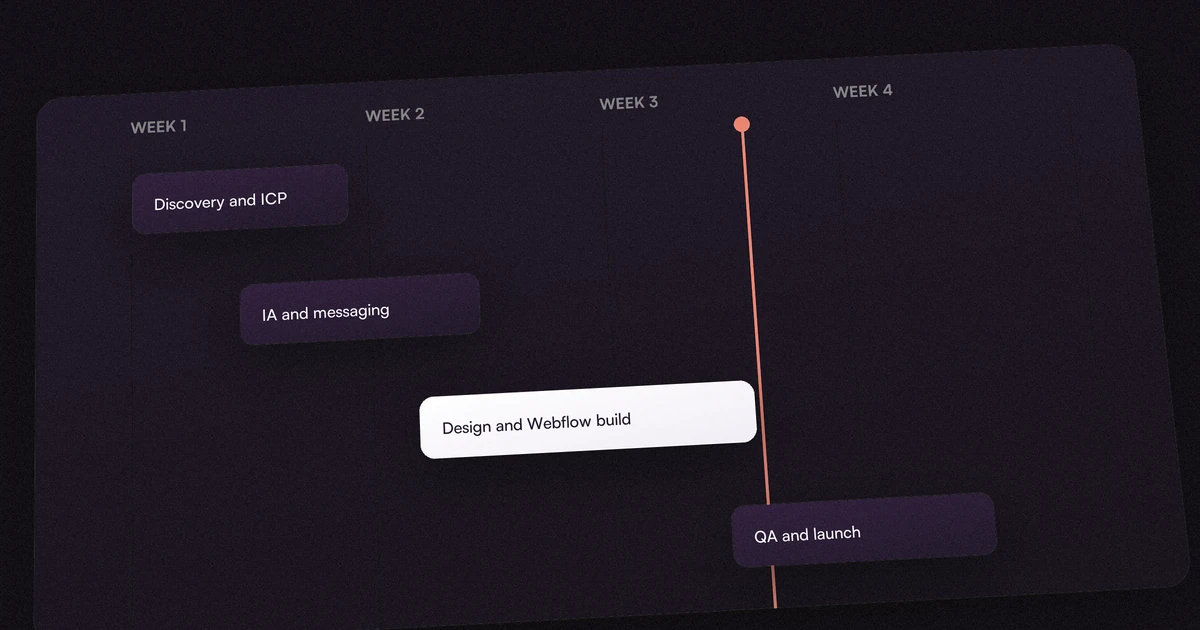

How we compress this to 3–4 weeks
Our published timeline for a full B2B SaaS site rebuild is 3–4 weeks. That's dramatically faster than even the "simple" tier above, and it's a fair question to ask how. Three things make the compression possible without skipping steps:
- A pre-built design system, not a blank canvas — components, spacing, and interaction patterns are ready before your kickoff call, so design time goes into your specific content and positioning, not reinventing buttons.
- Parallel tracks instead of a relay. Content, design, and Webflow build happen concurrently with tight sync points, instead of each phase waiting for the last one to fully finish.
- Ruthless page-count discipline. We scope the pages that actually drive pipeline first and treat "nice to have" pages as a fast-follow, which is also what keeps scope creep — the timeline killer above — from creeping in.
The tradeoff is real: this works best when your team can turn around content and feedback quickly and when the scope is genuinely a marketing site, not a large content migration on top of a rebuild. If either of those doesn't fit, a longer timeline in the ranges above is the honest answer, whoever builds it. You can see what a 3–4 week rebuild actually ships in our portfolio.
| Scope | Timeline | What's included |
|---|---|---|
| Simple SaaS site or MVP | 6–8 weeks | — |
| Standard B2B SaaS marketing site | 8–16 weeks12–16 weeks is the realistic middle | Multiple page types, a blog, some integrations |
| Complex B2B build | 18–30 weeks | Custom flows, localization, or a large content migration |
| Our compressed rebuildthat's us | 3–4 weeks | Pre-built design system, parallel tracks, page-count discipline |

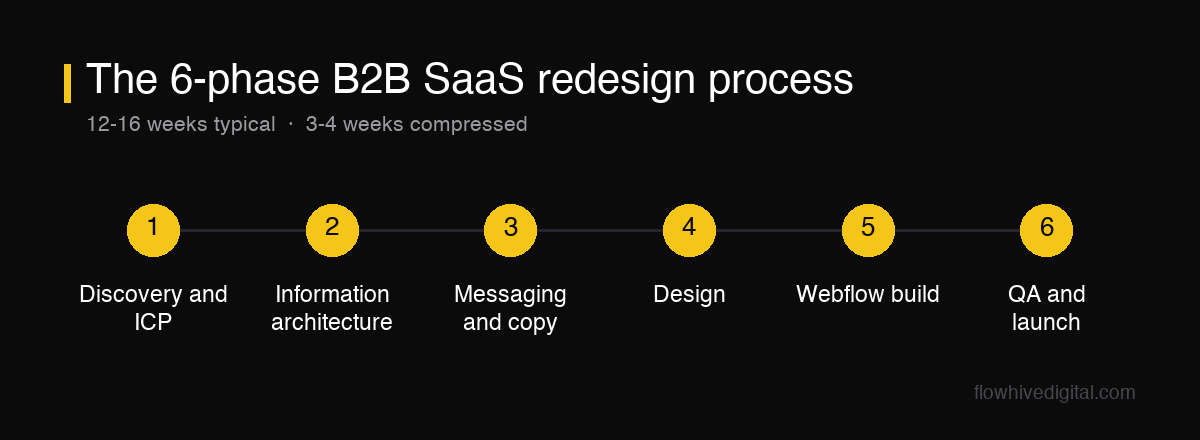

The 6-phase process
- Discovery and ICP. Who the site needs to convert, what objections show up in sales calls, and what's actually broken in the current funnel — not just "make it look modern."
- Information architecture. Page map, navigation, and how each page type (product, pricing, case studies, blog) fits the buyer journey.
- Messaging and copy. Positioning locked before visual design starts — designing around placeholder copy is how projects end up redesigning the redesign.
- Design. Wireframes into full visual design, built from a component system rather than one-off pages.
- Webflow build. CMS structure, interactions, and responsive behavior, built in parallel with content finalization.
- QA and launch. Cross-browser and mobile QA, redirect map execution, analytics verification, and a staged go-live.
The pre-launch SEO checklist
This is the phase that decides whether a redesign protects your rankings or resets them. Before launch:
- Full URL inventory of the current site — every indexed page, not just the ones in the main nav.
- 1:1 redirect map from every old URL to its new equivalent, tested before go-live, not written the day of.
- Metadata carried over or improved — titles, descriptions, and structured data mapped page by page, never left blank on launch.
- Sitemap regenerated and resubmitted in Search Console the day the new site goes live.
- Analytics and conversion tracking verified live before launch, not discovered broken a week later.
- Core Web Vitals checked on staging — a redesign that looks better but loads slower can cost you rankings even with perfect redirects.
Treat this checklist as a scorecard when you're briefing any agency, including us: a full URL inventory, a tested redirect map, carried-over metadata, and a resubmitted sitemap should all be explicit line items in the proposal, not assumed. If a quote doesn't mention them, ask why before you sign.
What a redesign costs
Cost tracks scope more than anything else. Current published ranges for B2B redesigns run from roughly $10,000 for a tightly scoped project up to $50,000 or more for a complex build with heavy integrations, with full-service agency engagements sometimes running well past that. Ongoing post-launch support, when it's a separate retainer rather than bundled in, commonly runs $1,000–$3,000 a month. We break down what actually drives a quote up or down — page count, CMS collections, integrations, content migration — in our Webflow agency cost guide, and publish our own packages (from $3,000) and maintenance plans (from $1,500/month) on our pricing page rather than quoting only after a call.
A redesign usually costs about the same as a first build, sometimes more, not less — a common assumption is that "you already have a site" makes it cheaper, but a redesign adds work a first build doesn't have: auditing what to keep, migrating and re-tagging existing content, and protecting the SEO equity and analytics history the current site has already earned. Budget for that as real scope, not a discount.
Measuring success after launch
A redesign isn't done at launch — it's done when you know whether it worked. Track, at minimum:
- Demo or trial conversion rate in the 60 days after launch, compared to the 60 days before. This is the number a redesign is ultimately for.
- Organic rankings and traffic for your top existing pages, watched weekly for the first month to catch redirect gaps early.
- Page speed and Core Web Vitals on the new site versus the old one — a real before/after, not an assumption.
- Bounce and engagement on key pages — pricing, product, and demo-request pages specifically, since these are where a redesign should move the needle first.
Our own published benchmark is a 30–40% lift in demo conversion within 60 days of launch — a claim we make about our own process, not an industry average, and worth holding any agency to a specific, checkable number like it rather than "better results." If you want a straight read on where your project fits — a compressed rebuild or a longer, larger scope — get in touch and we'll tell you honestly which one it is.
FAQ
Should I redesign or just refresh?
If the core structure, navigation, and CMS still fit how the business sells today and the problems are mostly visual or content-level, a refresh is faster and cheaper. Redesign when the information architecture itself no longer matches your buyer journey, or when the platform is limiting what marketing can do without engineering.
Will I lose SEO rankings during a redesign?
Not if the redirect map, metadata, and sitemap resubmission are handled before launch, not after. Ranking loss in redesigns almost always traces back to missing redirects or metadata dropped during the rebuild, not the new design itself. We cover this in more depth for platform migrations specifically in our Webflow vs WordPress comparison.
How do I brief an agency so the scope doesn't creep?
Write down the page list, CMS collections, and revision rounds before the kickoff call, and get explicit agreement on what counts as a change order versus what's included. Scope creep, not the design work itself, is the most commonly cited reason redesigns run over their timeline.
Do I need to plan for AI-driven search discovery now?
It's an increasingly common recommendation in current redesign guidance: structure content so it directly and clearly answers the questions buyers ask, since a growing share of B2B research now runs through AI assistants alongside traditional search. Clear headings, direct answers early in each section, and structured data all serve this without requiring a separate strategy from good SEO practice.
What's the realistic timeline if my team is slow to turn around feedback?
Add time proportional to your slowest approval loop — a compressed 3–4 week process assumes fast content and feedback turnaround from your side. If your organization typically needs a week per review round, plan for the standard 12–16 week range instead, regardless of who builds it.
